Cabin outfitting control

Every cabin. Every work package. One view.

Sightyard steers the cabin outfitting of cruise newbuilds. Crews record status with one tap in the cabin. Yard, contractor and owner see the same picture, deck by deck.

S693 · Completion 3,437 cabins · 47% accepted COMPLETION SCHEDULE FLOW FZ 1FZ 2FZ 3FZ 4 1918171615141312111098765 BOW STERN
Ship overview on the demo ship: 15 decks, 3,437 cabins, one cell per cabin.
  • Open
  • In progress
  • Accepted
  • Punch open
  • Blocked

The task

Three thousand cabins, one takt, three parties.

A large cruise ship carries more than 3,000 cabins. Each one passes through installation, checks and acceptance in a fixed sequence, fire zone by fire zone.

Yard, contractor and owner each keep their own lists. When the lists differ, the takt breaks: crews wait, inspections slip, punch items get lost between Excel files.

3,000+
cabins per ship
15
decks, each split into fire zones
3
inspection gates per cabin: Pre, First, Final
1
tap to record a work package

Frame it. Fix it. Finish it.

Three steps per cabin.

  1. 1 · Frame it

    Set the scope

    Decks, fire zones, cabin types and work packages come from the yard structure. Each work package carries its activities, its contractor and its planned dates. This is Advanced Work Packaging, applied to cabins.

  2. 2 · Fix it

    Record and resolve

    The crew scans the QR code at the cabin door and sets the status with one tap. Defects go into the punch list with photo, component and responsible contractor. Everything works offline and syncs later.

  3. 3 · Finish it

    Inspect and accept

    Pre, First and Final inspection follow as gates. Sign-offs are recorded with name and time. A cabin is finished when every work package is accepted and no critical punch item is open.

Product

Two surfaces, one data set.

In the cabin

A rugged Android phone, installed as a web app. No app store, no password for the crew on shared devices. Large touch targets for gloves, readable in daylight, fully usable without network.

  • QR scan opens the cabin
  • One tap per work package
  • Punch item with photo in under a minute
  • Offline queue with visible sync status

In the site office

The management cockpit shows the whole ship as a raster, deck by deck and fire zone by fire zone. Colour modes for completion, schedule and flow. Click through from ship to deck to cabin.

  • Ship overview with completion, schedule and flow modes

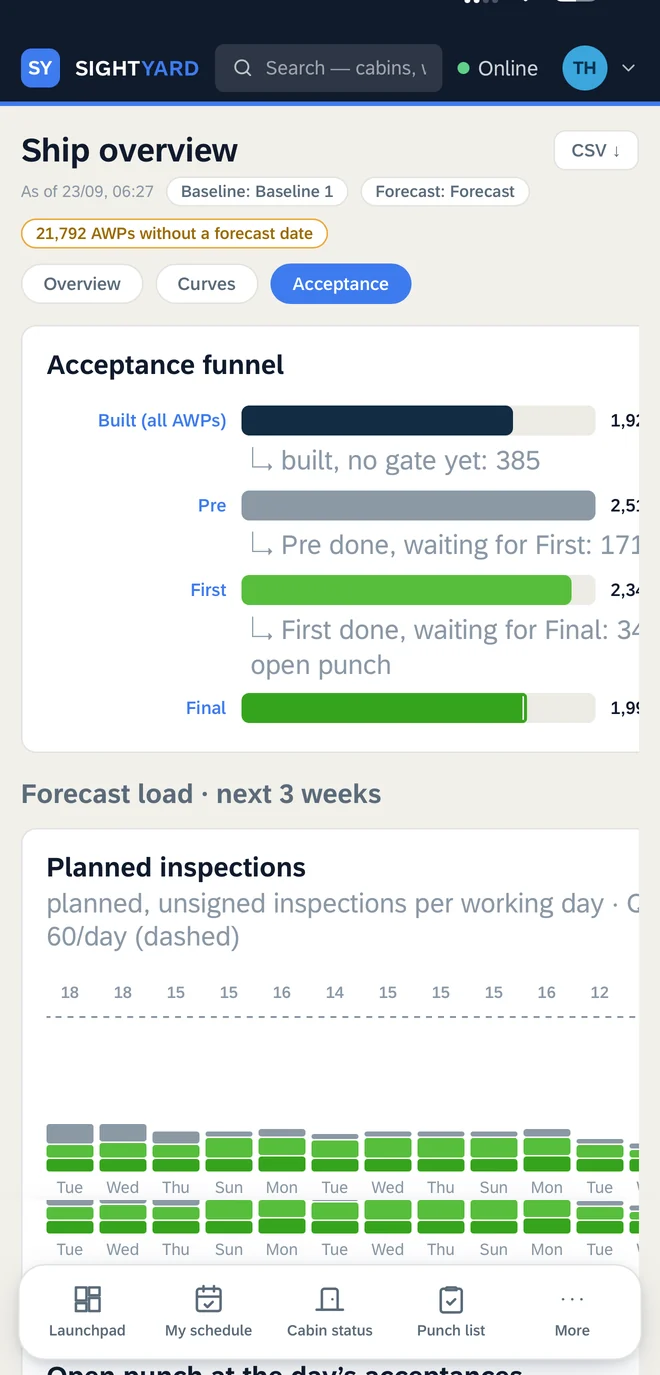

  • S-curve, SPI and throughput per week
  • Delay ranking by deck, fire zone or trade
  • Punch list with filters, series defects and CSV export

Modules

What the cabin module covers today.

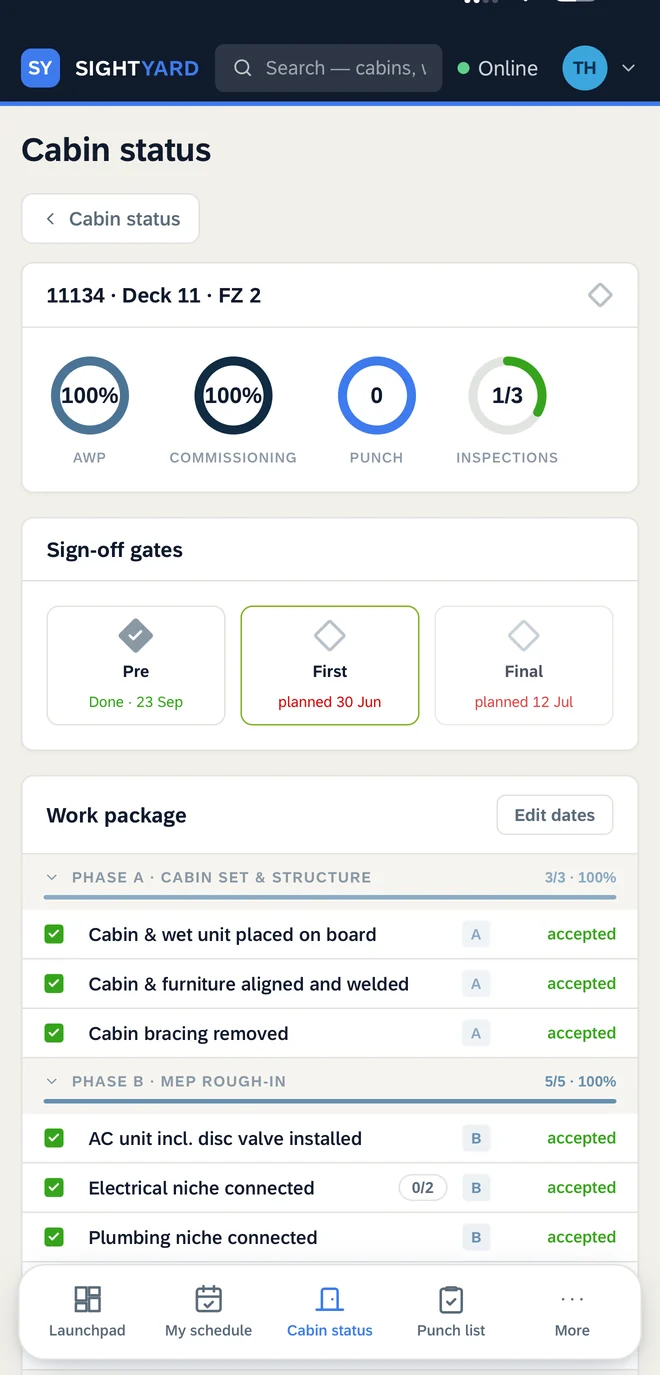

  • Cabin status

    Rollup per cabin, work packages by phase, inspection gates.

  • Complete schedule

    Baseline and forecast per work package, yard calendar, drift.

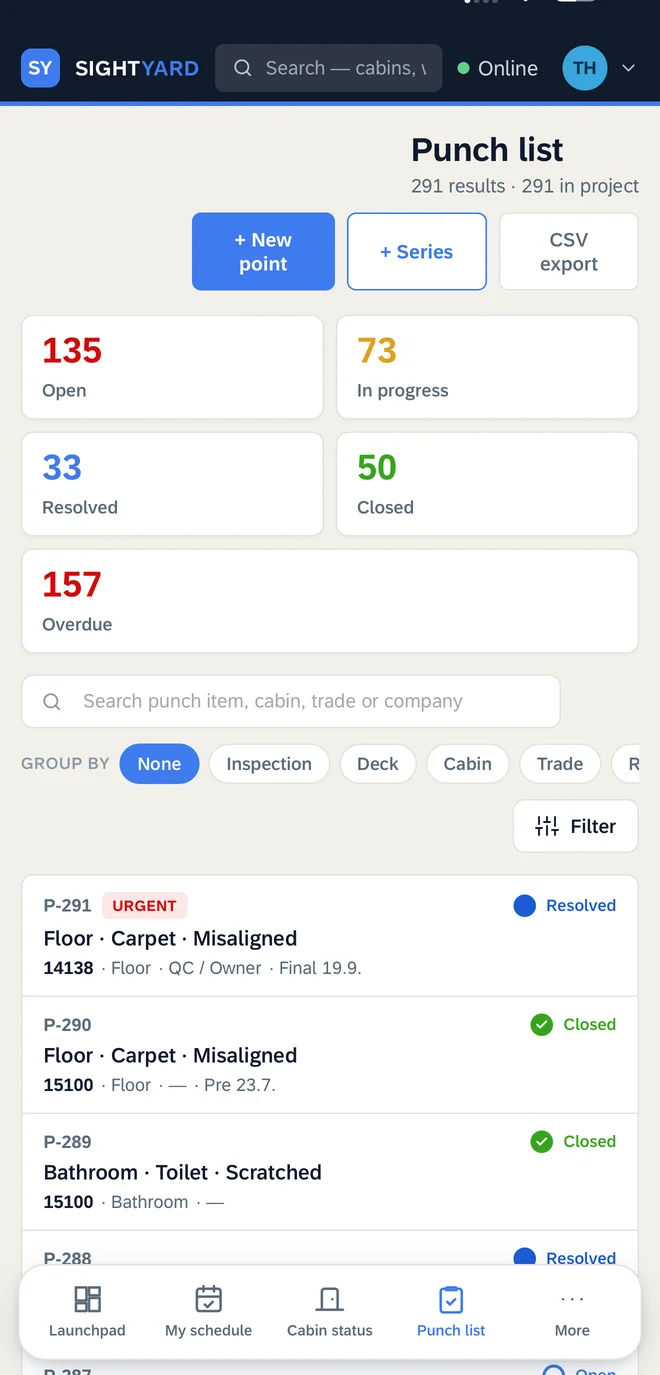

  • Punch list

    Structured defects by segment, component and attribute. Ball in court.

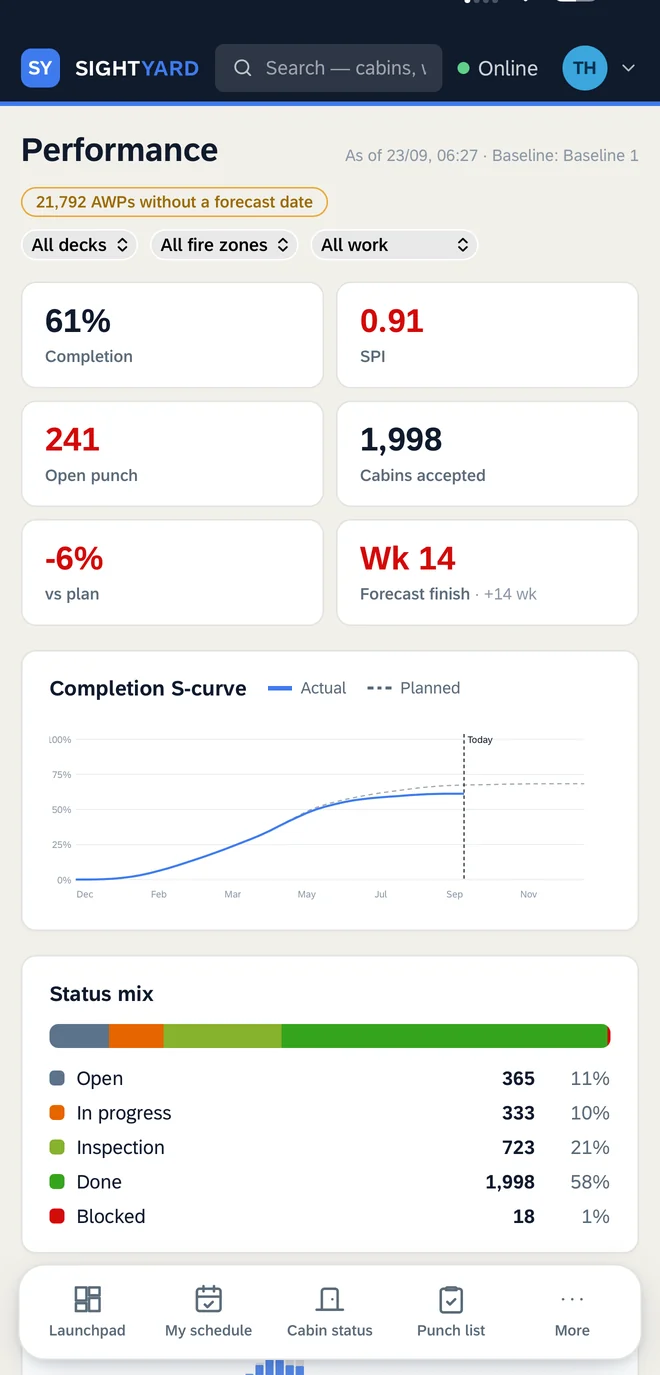

  • Performance

    Completion, SPI, throughput, completion by deck.

  • Ship overview

    Every cabin as a cell. Three colour modes, drill down to deck and cabin.

  • My scope

    Personal work lot and day list for foremen and specialists.

  • Administration

    Structure import, work packages, awarding, defect catalog, users, audit log.

  • Offline and sync

    Durable write queue on the device. Idempotent sync on reconnect.

Method

Built on a published standard.

Sightyard applies Advanced Work Packaging (AWP) to cabin outfitting. AWP is documented by the Construction Industry Institute and COAA in IR 272-2 and is an established best practice for large capital projects.

From AWP we take the typed work package as the unit of delivery, the constraint-free package as the unit of execution, and status recorded at activity level. The cabin sequence is the path of construction.

  • Multi-tenant: several newbuilds per yard, one system
  • Roles limited to their own scope: yard steers, contractor executes, owner accepts
  • Append-only change log for every action, with user and time
  • Narrow SAP interface over stable work package and cabin identifiers
  • Runs on a European cloud stack, data stays in the tenant

Roadmap

From status to forecast.

The cabin module records what happened. The next layer works out what happens next. It builds a dependency graph across cabins and measures real velocity from the change log.

Every recommendation shows its reasoning. People decide, especially at sign-off.

  • 01

    Readiness lists

    Which work packages can start now, and which single one unlocks the most.

  • 02

    Backward planning

    What must be finished for the First inspection in fire zone 4 in week 22, and what is missing.

  • 03

    Forecast with confidence

    Will the milestone hold at current speed. The answer is a probability instead of a plan date.

  • 04

    Quality hotspots

    Which component fails repeatedly, on which deck, from which batch.

Contact

See it on your ship.

We show Sightyard on a demo ship with 3,437 cabins, or on your own structure if you send us a deck list. Thirty minutes online, or on site at the yard.
